Feeds:
Posts
Comments

Posts Tagged ‘litigation’

Jennette Barnes/CAI

Pointing to the potential financial implications for GE Vernova, Recharge News cites this serious fraud accusation by Vineyard Wind (VW):

“This exceptional misconduct includes [GE Vernova’s] intentional scheme to falsify critical quality assurance data… and to intentionally misrepresent the quality of those blades to [Vineyard Wind] in a brazen fraudulent, and willful breach of the TSA, ultimately resulting in the catastrophic blade failure…”

Recharge also discusses the findings of the Project Engineer appointed by VW to resolve claims between parties. Under the terms of the contract, the engineer’s determinations are binding unless overturned in arbitration.

  • The engineer determined that GE Vernova was liable for project delays, blade defects, vessel costs, and a $185m rescission of previously certified payments.
  • The damage claims issued by the project engineer total $853m.
  • On the basis of those determinations, VW withheld 100% of the outstanding invoices issued by GE Vernova. Even netted against sums allegedly owed to GE Vernova, VW says the turbine maker owes around $545m.
  • Per the contract, there are no limitations on liability in cases of “fraud, gross negligence, deliberate default or willful misconduct.”

My take: VW’s charges against GE Vernova will be resolved in the courts. However, VW is the lessee and operator, and is thus the party responsible to the Federal govt for project safety and environmental protection.

  • Operator responsibility is a fundamental tenet of the OCS regulatory program. As lessee/operator, VW bears ultimate responsibility for project safety and environmental protection.
  • VW is responsible for contractor selection, management, and oversight.
  • If a contractor violates a regulation, the violation notice is given to the operator. If a contractor causes pollution, the operator is responsible for the cleanup.
  • DNV, the Certified Verification Agent (CVA) hired by VW, was required to verify the design, fabrication, and installation procedures. Did they raise any issues to VW and the regulators?
  • At VW’s request, BOEM waived a Fabrication and Installation Report (FIR) requirement so the project could stay on schedule. The FIR addresses quality assurance measures, so the waiver is highly relevant and concerning.
  • Did the division of responsibilities between BOEM and BSEE weaken regulatory oversight? BOEM, ostensibly just the leasing bureau, should not have been authorized to grant departures that could affect structural integrity and operational safety.
  • It’s surprising that VW has not been cited for civil penalties resulting from the blade failure and the resulting environmental damage.
  • How can a judge prevent a contractor from stopping work for an operator that has filed serious fraud allegations against the contractor, has stopped making payments, and has, along with the Governor, declared the project to be complete?

Lastly, nearly two years after the blade failure, we are still awaiting BSEE’s investigation report.

Read Full Post »

On 5/14/2026, the U.S. District Court for the Central District of California dismissed the complaint filed by the Center for Biological Diversity (CBD) against the Dept. of the Interior. This was one of the less prominent cases challenging Sable Offshore’s oil and gas operations in the Santa Ynez Unit.

The CBD had challenged an April 2025 BOEM decision concluding that Sable was not required to revise its development and production plan for the SYU. They sought a court order requiring a revised plan. This suit seemed to be a stretch, so its dismissal is not a surprise.

Per the Dept. of Justice, the court dismissed the lawsuit because the plaintiffs’ asserted procedural injury had no basis in the statute, was not traceable to any action by BOEM, and could not be redressed by an order of the court. (Other than that, it was just fine. 😉)

Among other problems the court identified with the plaintiffs’ case, they invoked a provision of the statute that governs “approval of a development and production plan,” not revision of an already-existing plan. It will be interesting to see the full decision so that we can better understand the context for that statement. Distinguishing revised plans in that manner could have significant policy implications.

For a full update on Sable litigation, see the section of their Quarterly Report beginning on p. 12.

Read Full Post »

California Attorney General Bonta asks the Court to stay Energy Secretary Wright’s Order directing Sable, under the Defense Production Act to restart production and preliminarily enjoin Defendants, and all those acting in concert with Defendants (i.e. Sable), from enforcing or relying on it. See the attached Federal Court filing.

The AG’s irreparable harm and public interest arguments seem particularly weak, and this may not be the best time to attempt to halt a 20+% increase in California oil production.

Read Full Post »

The Constance Gee letter (pasted below) is entertaining no matter where you stand on the Vineyard Wind debacle. A couple of quotes 😉:

It’s been a mess from the beginning and in a mess it will end, but the current “he said she said” over who owes more millions to whom is especially trashy.

Poor Vineyard Wind doesn’t have a clue how to service and maintain the 62 turbines they’ve hammered into the seabed 15 miles off our coast, and they are upset that GE Renewables won’t hand over the troubleshooting manual.

The Vineyard Wind Court filing is accessible here.

Read Full Post »

damaged Vineyard Wind turbine – Cape Cod Times photo

Excerpt from p.3 of Vineyard Wind’s suit against GE Renewables (attached):

“As was widely reported in national and local news, in July 2024, one of the GER offshore blades collapsed and fell into the waters off Nantucket, necessitating a massive environmental cleanup, and a six-month construction hiatus during which GER performed a “root cause” analysis. That analysis concluded that 68 of the 72 GER blades installed at the Project (nearly all manufactured by GER in Gaspé, Canada) were also defective because they were inadequately bonded together, and were so poorly made that they were beyond repair. GER’s remediation plan required it to remove all of the blades and to replace all Gaspé blades with others manufactured at a different facility in Cherbourg, France.

Regulatory issues of concern:

    Read Full Post »

    Three wind turbines, including one with a damaged blade, at the Vineyard Wind offshore site in November 2024. Credit: Eleonora Bianchi / The New Bedford Light.

    Yet another chapter in the Vineyard Wind saga:

    New Bedford Light: Vineyard Wind on Wednesday sued its turbine supplier, GE Renewables, in civil court in Boston, alleging GE is breaching its contract and planning to abandon the project by April 28 — during the critical final stage of coming fully online.

    According to the complaint, GE filed a termination notice with Vineyard Wind in late February for its contracts to supply wind turbines and service and maintain them, citing more than $300 million in claims unpaid by Vineyard Wind.

    If GE exits, Vineyard Wind says, the project “will likely fail, leaving the windfarm stranded.”

    The New Bedford Light provides more details on the litigation.

    Remember, BOEM waived the “pay as you build” decommissioning financial assurance requirement for Vineyard Wind and subsequently relaxed financial assurance requirements for all offshore wind projects.

    Read Full Post »

    Attached is John Smith’s comprehensive summary of lawsuits related to Sable Offshore’s attempts to restart Santa Ynez Unit production.

    If you are keeping score, there are 10 separate cases including a class action lawsuit filed by investors. New legal battles are sure to follow given Sable’s OS&T strategy. Per John:

    The combined legal challenges, injunctions, and restraining orders have significantly delayed Sable’s restart plans and prompted the company to pursue an Offshore Storage and Treatment Vessel (OS&T) strategy, which was utilized to process SYU production in federal waters from 1981 – 1994, and transport oil to markets using tankers.

    Read Full Post »

    In addition to the Johnson filing, at least 7 other law firms (links below) have announced class action litigation alleging that Sable Offshore made false or misleading statements regarding the restart of Santa Ynez Unit production.

    Perhaps working in Sable’s favor is the fact that the Federal government (BSEE) made a similar production restart announcement nearly 2 months after Sable, declaring victory and seemingly taking credit for the achievement:

    This is a significant achievement for the Interior Department and aligns with the Administration’s Energy Dominance initiative, as it successfully resumed production in just five months.

    Will the Dept. of Justice intervene on behalf of Sable?

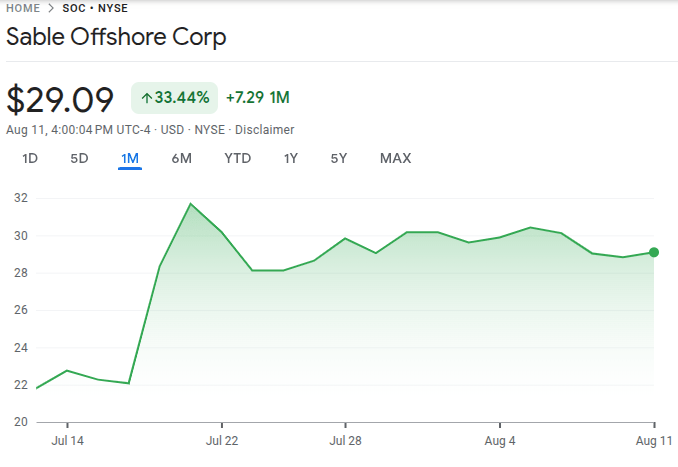

    Meanwhile, Sable’s share price rebounded in mid-July and is holding up surprisingly well (see below). Perhaps investors don’t see the class action suits as a significant incremental threat given the risks associated with decisions by 8 California agencies, Santa Barbara County, and various judges, and the persistent challenges by well-organized opponents of offshore production.

    Read Full Post »

    A new court filing (attached) informs that the Dept. of the Interior is reconsidering the Construction & Operations Plan (COP) approval for US Wind’s Maryland Offshore Wind (“MarWin”) Project (maps above). That approval is the subject of litigation filed by Ocean City MD and others.

    The key section of the Federal government’s filing is pasted below.

    1. An extension in this case is necessary as Interior intends to reconsider its COP approval and move in the District of Maryland—the first-filed case—for voluntary remand of that agency action. See, e.g., Util. Solid Waste Activities Grp. v. EPA, 901 F.3d 414, 436 (D.C.Cir. 2018) (recognizing that administrative agencies have the authority to reconsider their decisions). The outcome of Interior’s reconsideration has the potential to affect the Plaintiff’s claims in this case.

    Read Full Post »

    In the Independent, Nick Welsh aptly described the latest court decision in the long and winding road that Sable Offshore hopes will lead to Santa Ynez Unit production:

    When Judge Donna Geck got through ruling on the latest showdown between Sable Offshore Oil and Santa Barbara’s environmental establishment last Friday morning, it wasn’t clear if the no-nonsense judge cut the proverbial baby in half or kicked the can down the proverbial road.”

    Bottom line: The judge will “continue to bar the Fire Marshal from taking any steps to process Sable’s restart application until 10 days after Sable had received all the necessary permits and approvals from the myriad of state, federal, and local agencies that enjoy some degree of regulatory oversight over the proposed project.” Does that mean any agency, even one with a minor or questionable role, can block the project?

    As the author notes:

    “As of this writing, it’s not entirely clear which of those agencies have yet to issue Sable the permits it needs to start the restart process and when they’re likely to do so, if at all. Even less clear is whether there’s any agreement among the dueling parties as to which agencies have standing to even weigh in.”

    Read Full Post »

    Older Posts »
